Our process
At MD Construction, we believe transparency is essential for a smooth home improvement experience. Below you’ll find a clear breakdown of each step in our process, from securing permits and HOA approvals to completing your installation. We’ve included timeline estimates to keep you informed and confident throughout your project.
01
Administrative, Permitting, & HOA*
Create Job File
Design Job

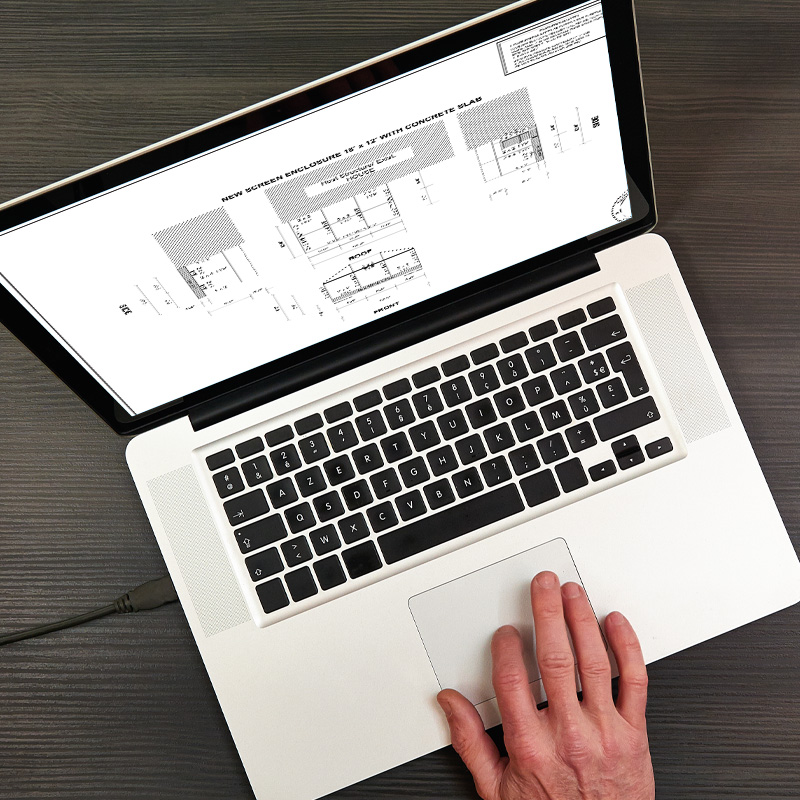

Request Engineering
Email Drawings to Home Owner
Submit HOA Application
Submit for County Approval
Receive Approved Permit
Send Job to Production
Entire process can take 4 – 8 weeks depending on County and HOA
Some HOA’s will not allow ARC applications from Vendors
We will provide all requested paperwork for the homeowner to submit online, in person, or via your online HOA portal if necessary

all time frames are estimates and subject to change at any time

all time frames are estimates and subject to change at any time
02
Once started, foundation work can take up to 2 weeks pending unforeseen delays such as weather
Homeowner is responsible for irrigation
03

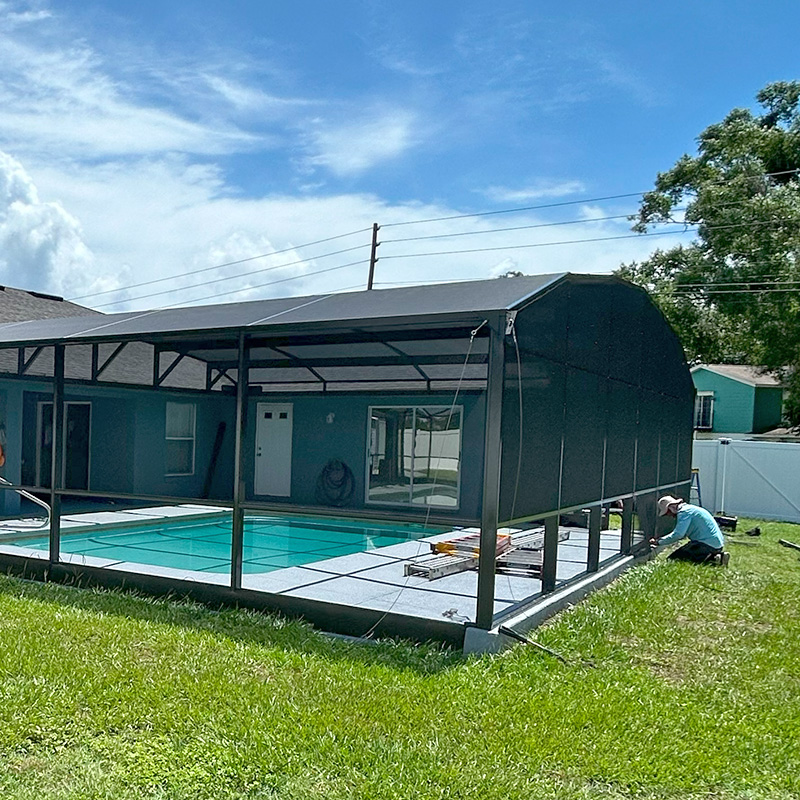

Installation**
Take Precise Measurements at Jobsite for Prefabrication
Pre-Fab in Our Warehouse
Schedule Installation Date
Install at Jobsite (Sunrooms see #4)
Third Payment Due at Start of Installation
Final Inspection by County
Final Concrete Paint (if applicable)
Final Payment Due
Installation are being scheduled 2 – 5 weeks AFTER all HOA & Permitting approvals (if no foundation) or 3 – 6 weeks AFTER Foundation completion

all time frames are estimates and subject to change at any time

04

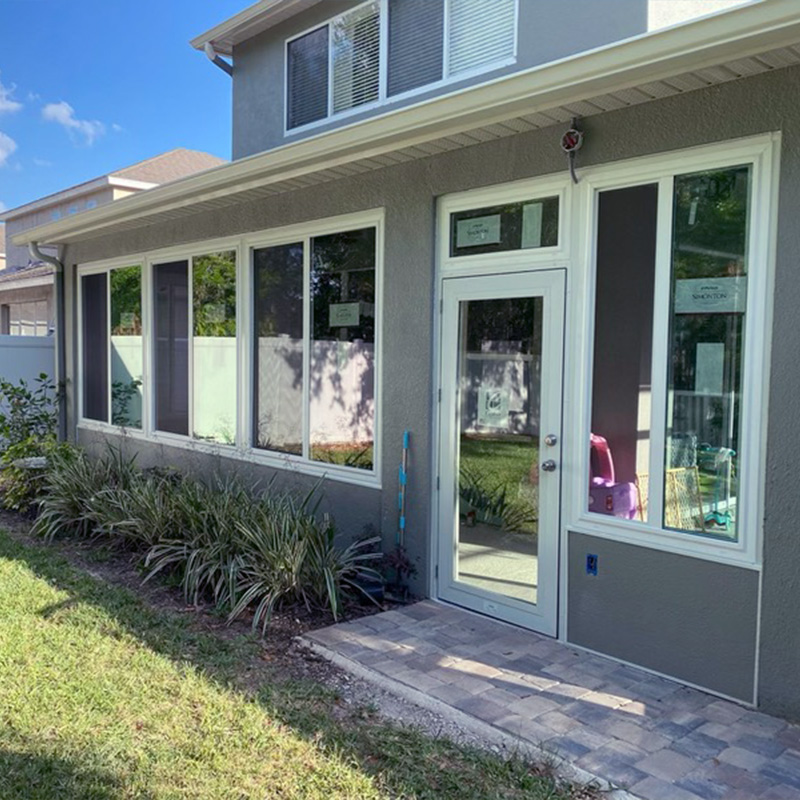

Sunrooms***
Take Measurements for Windows After Frame Install
Order Custom Windows
Schedule Electrical Rough
Electrical Rough & Framing Inspections by County
Install Windows
Schedule Electrical Trim
Final Inspections by County
Final Concrete Paint (if Applicable)
Final Payment Due
*Some cities require HOA approval BEFORE the permit application can be submitted.
**Foundations are currently scheduled 4–6 weeks AFTER ALL approvals have been received (HOA, permits, and plan approval). Screen walls installed under existing roofs do NOT require preliminary measurements and will NOT be prefabricated. Precise measurements are taken 1–2 weeks after the foundation is complete. Installation is currently scheduled 3–6 weeks AFTER foundation completion.
***Windows are custom-made to fit the installed frame. Measurements are taken once the frame installation is complete, and windows are ordered within 1–2 days. Production and shipping of windows currently take 12–14 weeks.
